Project Overview
Nikau Contractors Ltd was engaged by Port of Auckland to undertake the staged decommissioning of 34 end-of-life straddle carriers as part of a major port asset renewal programme.

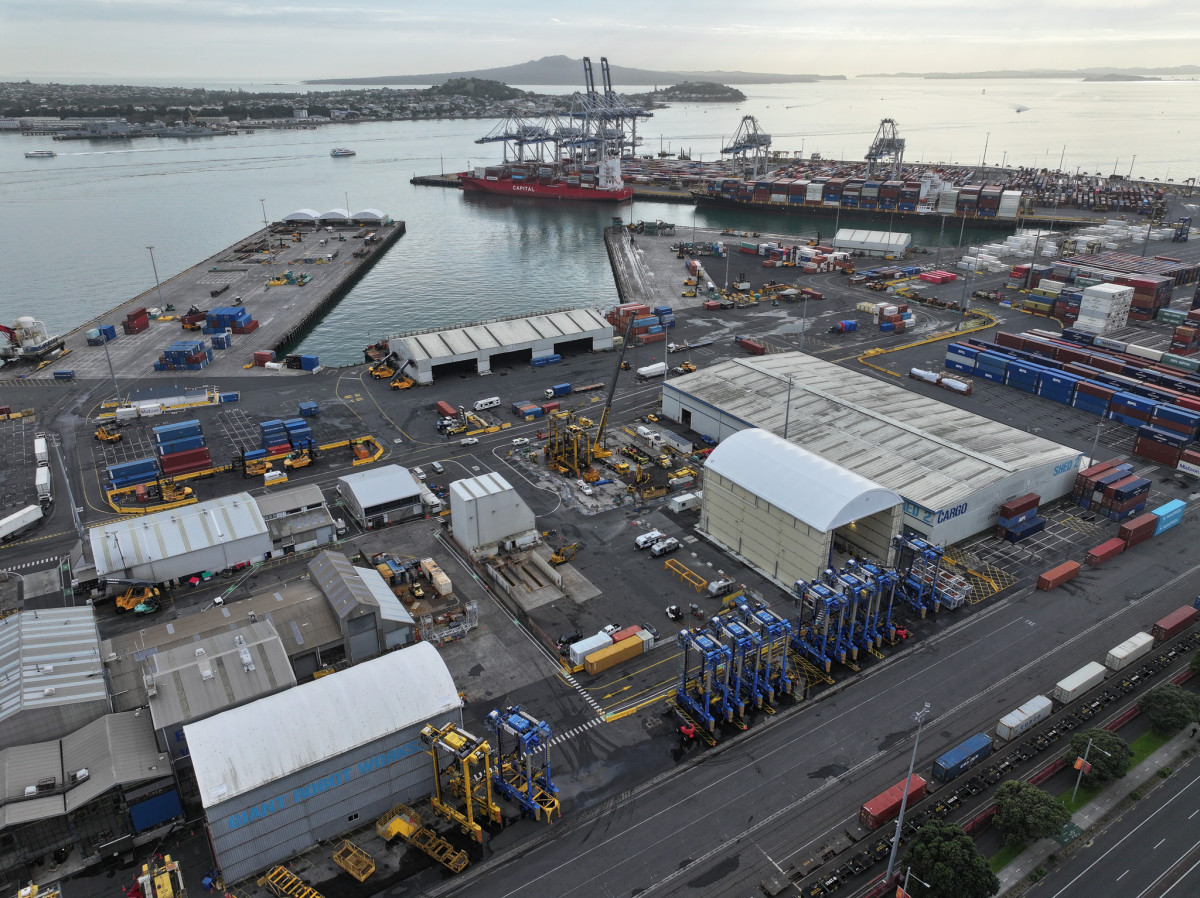

The works involved the controlled dismantling, removal, and recycling of large mobile port infrastructure within an active container terminal environment, requiring careful coordination to maintain port operations, manage safety interfaces, and minimise disruption to surrounding activities.
To reduce onsite processing impacts and operational nuisance, straddle carriers were dismantled into large sections and transported offsite to Nikau’s Meremere facility for further processing.
Environmental Focus
A key objective of the project was to deliver a high-recovery, low-impact decommissioning solution consistent with the Port of Auckland’s environmental and sustainability commitments.
Nikau implemented comprehensive environmental controls, including:
Full removal and management of diesel fuel, oils, and lubricants prior to dismantling
Segregation of recyclable materials at source
Offsite processing to minimise noise, dust, and congestion within the live port environment
This approach significantly reduced environmental risk while allowing port operations to continue safely and efficiently.
Recycling and Reuse
Material recovery and reuse were central to the project delivery. Key outcomes included:

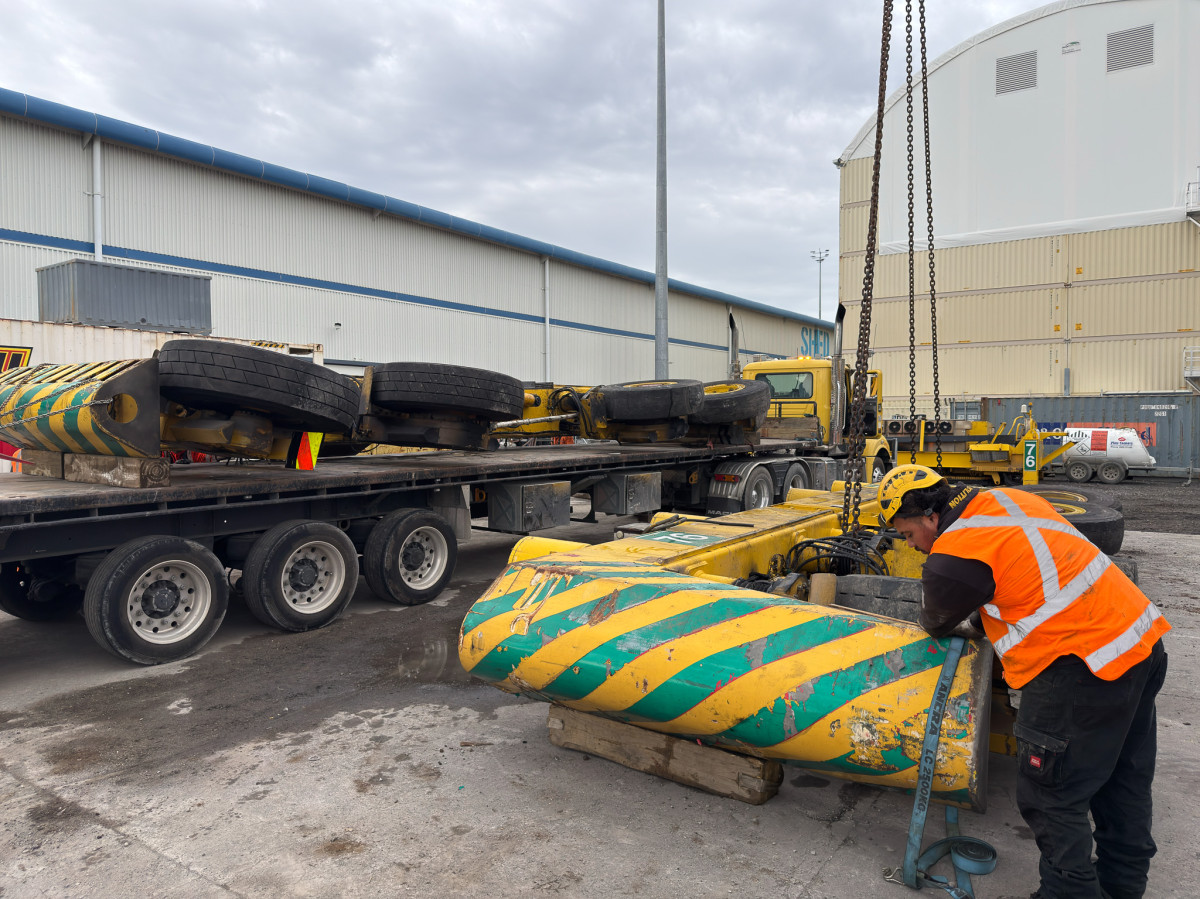

Removal and recycling of all straddle carrier tyres, transported to Tyrewise-approved recycling streams
Salvage, containerisation, and export sale of Caterpillar C13 engines and generators to an overseas buyer for reuse
Scrapping and export of approximately 2,200 tonnes of ferrous steel, diverted from landfill and reintroduced into global steel supply chains
This strategy maximised asset value recovery while supporting circular-economy outcomes.
Contractor Responsibilities
Nikau’s scope of works included full end-to-end decommissioning responsibility, including:
Hazardous Materials Management
Removal of all diesel, oils, and fluids prior to dismantling
Crane Operations

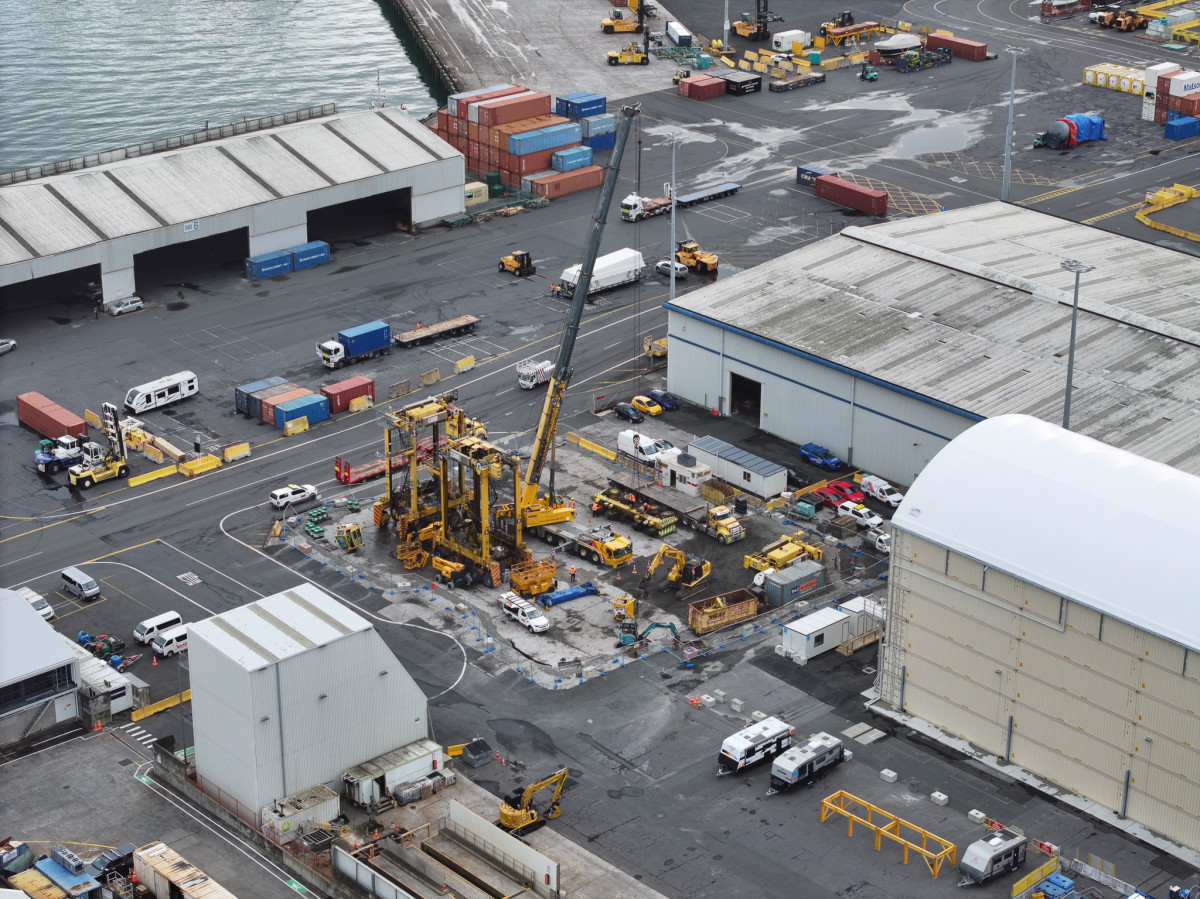

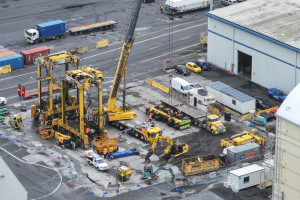

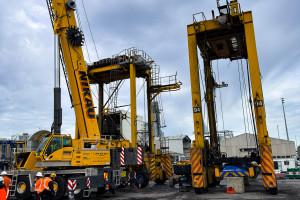

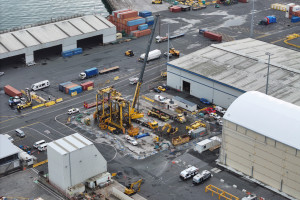

Cut-and-crane dismantling using Nikau’s 300-tonne mobile crane, allowing safe handling of large structural components

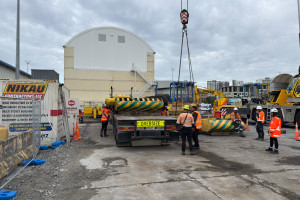

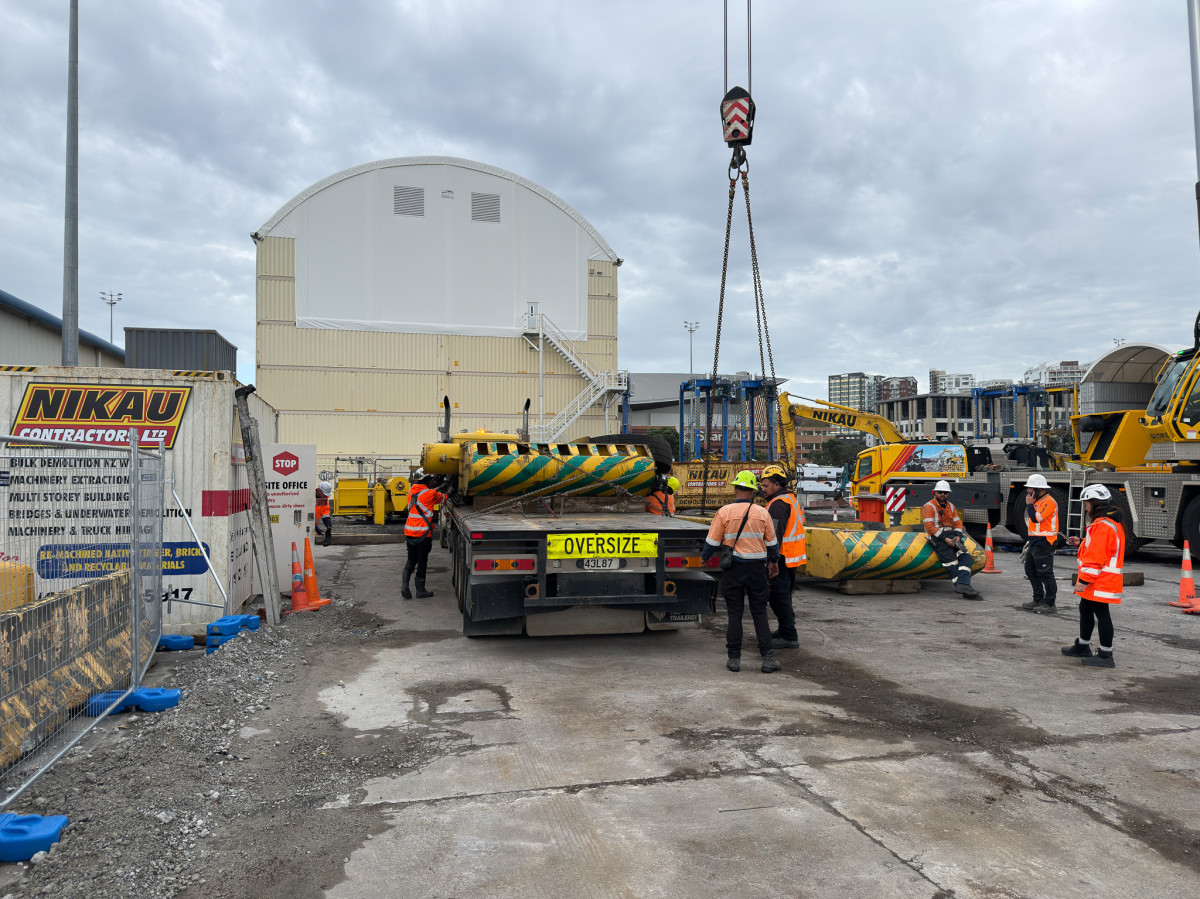

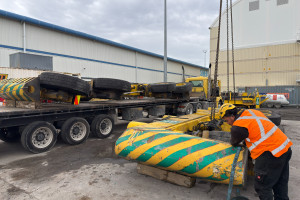

Heavy Lift & Transport
Transport of dismantled straddle carrier sections offsite to Nikau’s Meremere branch for processing

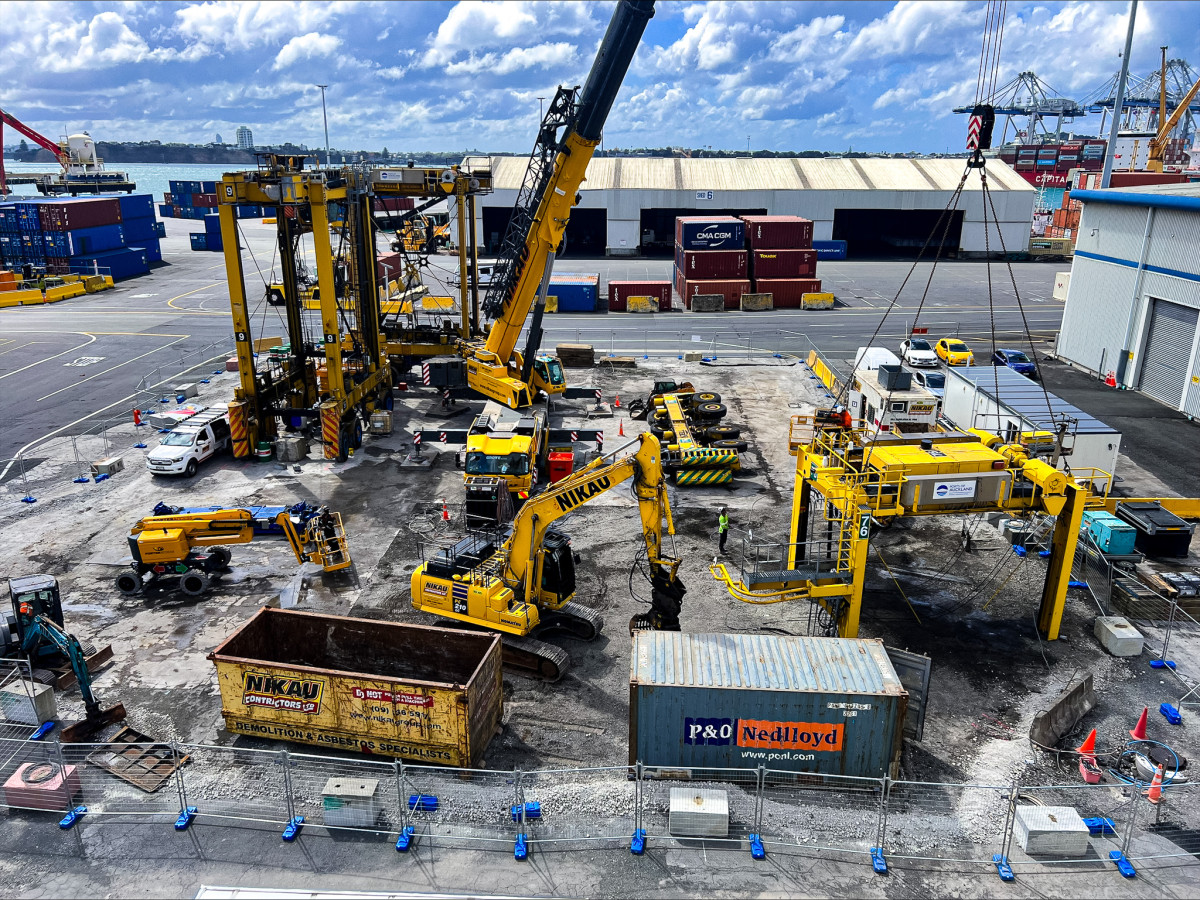

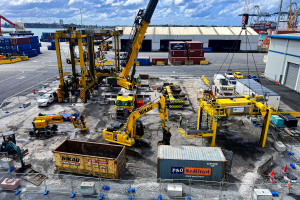

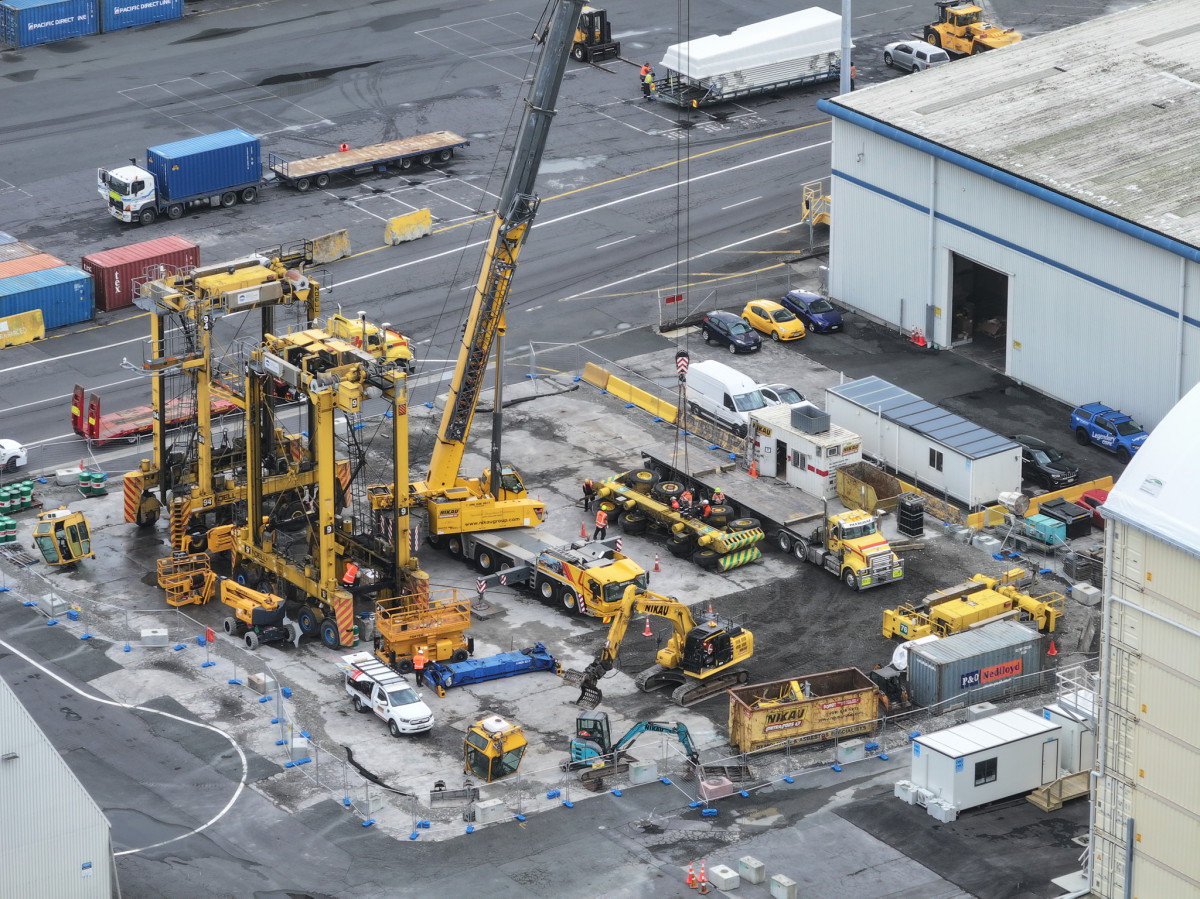

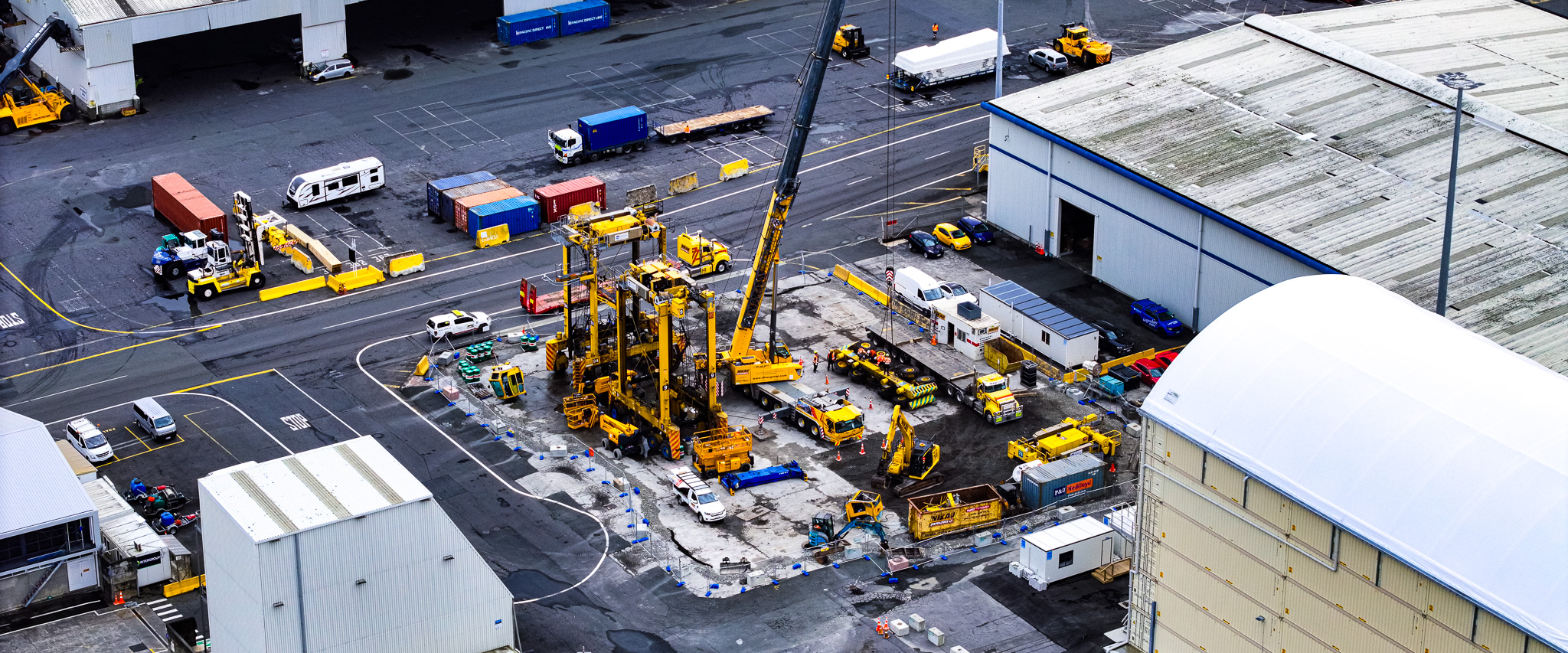

Deconstruction & Processing
Controlled dismantling of steel structures and mechanical assemblies
Segregation of ferrous and non-ferrous materials
Recycling & Export Logistics
Coordination of tyre recycling
Containerisation and export of engines, generators, and scrap steel
Project Challenges and Solutions
The decommissioning works were undertaken within a live container terminal, presenting complex challenges including interface management with port traffic, tight spatial constraints, and high-risk lifting operations.
Nikau addressed these challenges by:
Developing detailed lift planning and exclusion zone management
Sequencing works to align with port operational windows
Removing major processing activities offsite to reduce disruption
Applying proven heavy-industrial deconstruction methodologies supported by experienced crews and specialist plant
This approach ensured the project was completed safely, efficiently, and with minimal impact on port operations.
